Friday, 28 August 2015

Datafix Script to clear the RCV stuck pending transactions for Receipts

Scripts used for clearing the RCV stuck pending transactions

Scenario:
While receiving or correcting a PO, some time the transactions get stuck with out Processing due to delay in running receiving transaction processor (This happens sometimes if there is too many concurrent program's running at the back end)
Due to the above reason the PO is not received in the system and on hand quantity is not updated.
Even if we try to clear the stuck pending transactions system does not allow.
System also does not allow us to create receipt again for the PO till the stuck PO pending receiving transactions are cleared.
Solution:

We have written scripts to resolve this issue by way deleting the stuck PO pending transactions from the RCV table.
Step 1:  Query to identify the rcv_transactions_interface_id
Query: Select * from rcv_transactions_interface WHERE PO_HEADER_ID= (Give the PO header id of the diseased PO)

SELECT * FROM PO_HEADERS_ALL WHERE SEGMENT1=''
Example:
Select * from rcv_transactions_interface WHERE PO_HEADER_ID=1341737

SELECT * FROM PO_HEADERS_ALL WHERE SEGMENT1='550684'
Result: The above query will give the rcv_transactions_interface_ids of the stuck PO lines
Step 2:
Provide this information to the DBA and request the DBA team to follow the steps as provided in Oracle Note: Doc ID 303544.1 (How To Remove Pending and Error Receiving Transactions from Transaction Status Summary)
     a.  Run the script to check the backup tables: table_check23.sql
     b.  Run the appropriate datafix script:
          For 11.5.10 and r12.0: delete_stuck_rti_for_R11510 and R120.sql
          For 12.1 and above: delete_stuck_rti_for_R121_and_above.sql
---- ANIL APPANABOYINA

Monday, 24 August 2015

Bills Of Materials Setup Document with Costing

PROFILE OPTIONS IN BILLS OF MATERIALS

Profile Option
User
System Administrator
Requirements
User
User
Resp
App
Site
Required?
Default Value

BOM: Check for Duplicate Configuration
-

http://docs.oracle.com/cd/A60725_05/html/comnls/us/bom/t_chkmrk.gif
Optional
No
BOM: Component Item Sequence Increment
-
http://docs.oracle.com/cd/A60725_05/html/comnls/us/bom/t_chkmrk.gif
http://docs.oracle.com/cd/A60725_05/html/comnls/us/bom/t_chkmrk.gif
http://docs.oracle.com/cd/A60725_05/html/comnls/us/bom/t_chkmrk.gif
http://docs.oracle.com/cd/A60725_05/html/comnls/us/bom/t_chkmrk.gif
Optional
10
BOM: Configuration Item Delimeter
-

http://docs.oracle.com/cd/A60725_05/html/comnls/us/bom/t_chkmrk.gif
Optional
No
BOM: Configuration Item Type
-

http://docs.oracle.com/cd/A60725_05/html/comnls/us/bom/t_chkmrk.gif
Optional
No
BOM: Days Past Before Starting Cutoff of Order Entry Bills
-

http://docs.oracle.com/cd/A60725_05/html/comnls/us/bom/t_chkmrk.gif
Optional
0
BOM: Default Bill of Material Levels
-
http://docs.oracle.com/cd/A60725_05/html/comnls/us/bom/t_chkmrk.gif
http://docs.oracle.com/cd/A60725_05/html/comnls/us/bom/t_chkmrk.gif
http://docs.oracle.com/cd/A60725_05/html/comnls/us/bom/t_chkmrk.gif
http://docs.oracle.com/cd/A60725_05/html/comnls/us/bom/t_chkmrk.gif
Optional
1
BOM: Default WIP Supply Values for Components
-

http://docs.oracle.com/cd/A60725_05/html/comnls/us/bom/t_chkmrk.gif
Optional
Yes
BOM: Hour UOM
-

http://docs.oracle.com/cd/A60725_05/html/comnls/us/bom/t_chkmrk.gif
Optional
1 ?
BOM: Inherit Option Class Operation Sequence Number
-

http://docs.oracle.com/cd/A60725_05/html/comnls/us/bom/t_chkmrk.gif
Optional
No
BOM: Model Item Access
-
http://docs.oracle.com/cd/A60725_05/html/comnls/us/bom/t_chkmrk.gif
http://docs.oracle.com/cd/A60725_05/html/comnls/us/bom/t_chkmrk.gif
http://docs.oracle.com/cd/A60725_05/html/comnls/us/bom/t_chkmrk.gif
http://docs.oracle.com/cd/A60725_05/html/comnls/us/bom/t_chkmrk.gif
Optional
Yes
BOM: Perform Lead Time Calculations
-

http://docs.oracle.com/cd/A60725_05/html/comnls/us/bom/t_chkmrk.gif
Optional
No
BOM: Planning Item Access
-
http://docs.oracle.com/cd/A60725_05/html/comnls/us/bom/t_chkmrk.gif
http://docs.oracle.com/cd/A60725_05/html/comnls/us/bom/t_chkmrk.gif
http://docs.oracle.com/cd/A60725_05/html/comnls/us/bom/t_chkmrk.gif
http://docs.oracle.com/cd/A60725_05/html/comnls/us/bom/t_chkmrk.gif
Optional
Yes
BOM: Standard Item Access
-
http://docs.oracle.com/cd/A60725_05/html/comnls/us/bom/t_chkmrk.gif
http://docs.oracle.com/cd/A60725_05/html/comnls/us/bom/t_chkmrk.gif
http://docs.oracle.com/cd/A60725_05/html/comnls/us/bom/t_chkmrk.gif
http://docs.oracle.com/cd/A60725_05/html/comnls/us/bom/t_chkmrk.gif
Optional
Yes
BOM: Update Resource UOM
-

http://docs.oracle.com/cd/A60725_05/html/comnls/us/bom/t_chkmrk.gif
Optional
No

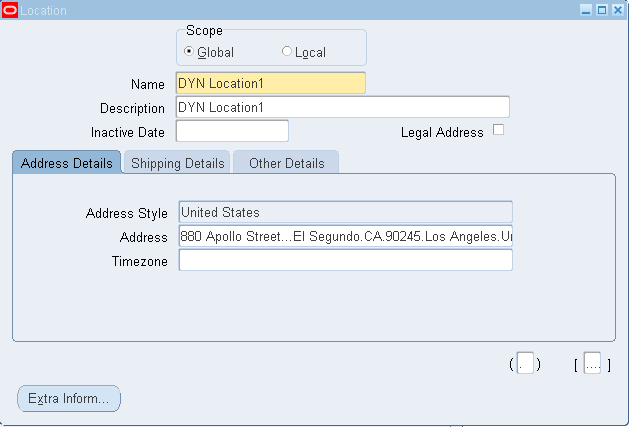

STEP 1: CREATE LOCATIONS
Define the manufacturing Location
Responsibility: Bills of Materials Navigation: Setup  > Locations

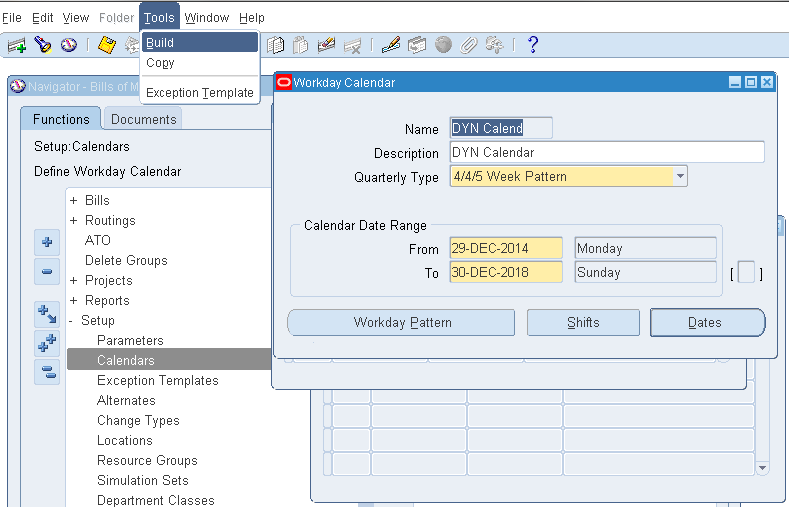

STEP 2: CREATE CALENDAR

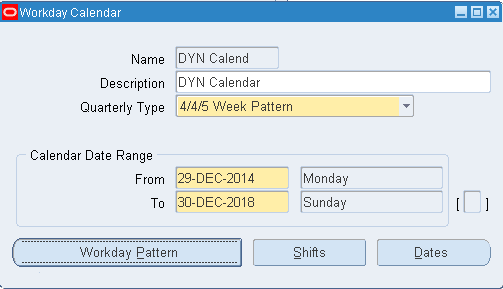

Define the manufacturing Calendar
Responsibility: Bills of Materials Navigation: Setup > Calendars

Define Workday Pattern, Shifts & Timings:

Build Calendar:

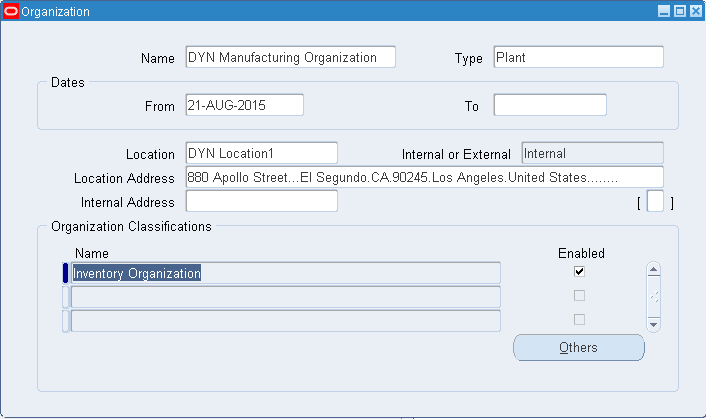

STEP 3: CREATE MANUFACTURING ORGANIZATION

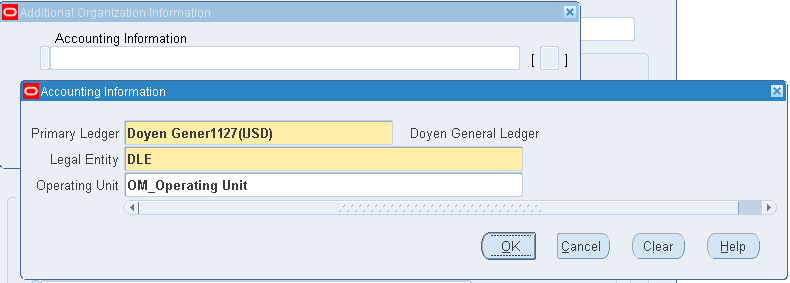

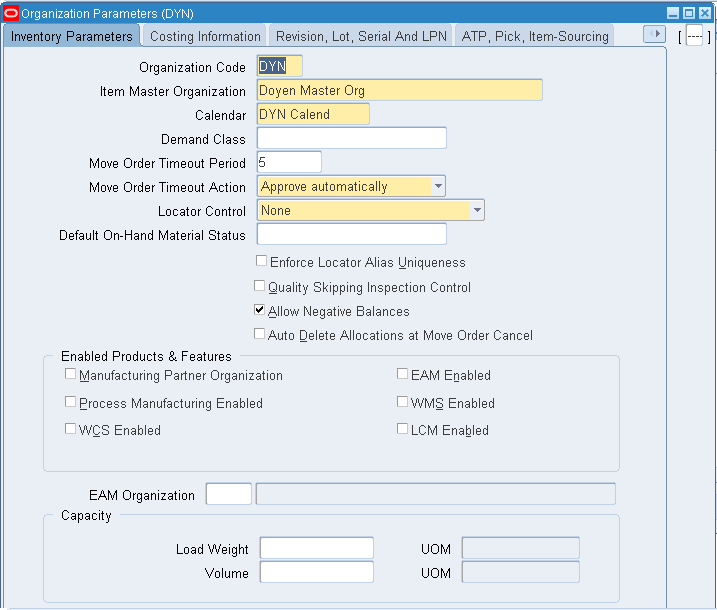

Responsibility: Inventory Navigation: Setup > Organizations > Organizations
Enter Accounting Information:

Enter Inventory Information:
Create a Standard Costing Organization and assign the manufacturing calendar and enter all the required GL Code combinations in accounts fields.

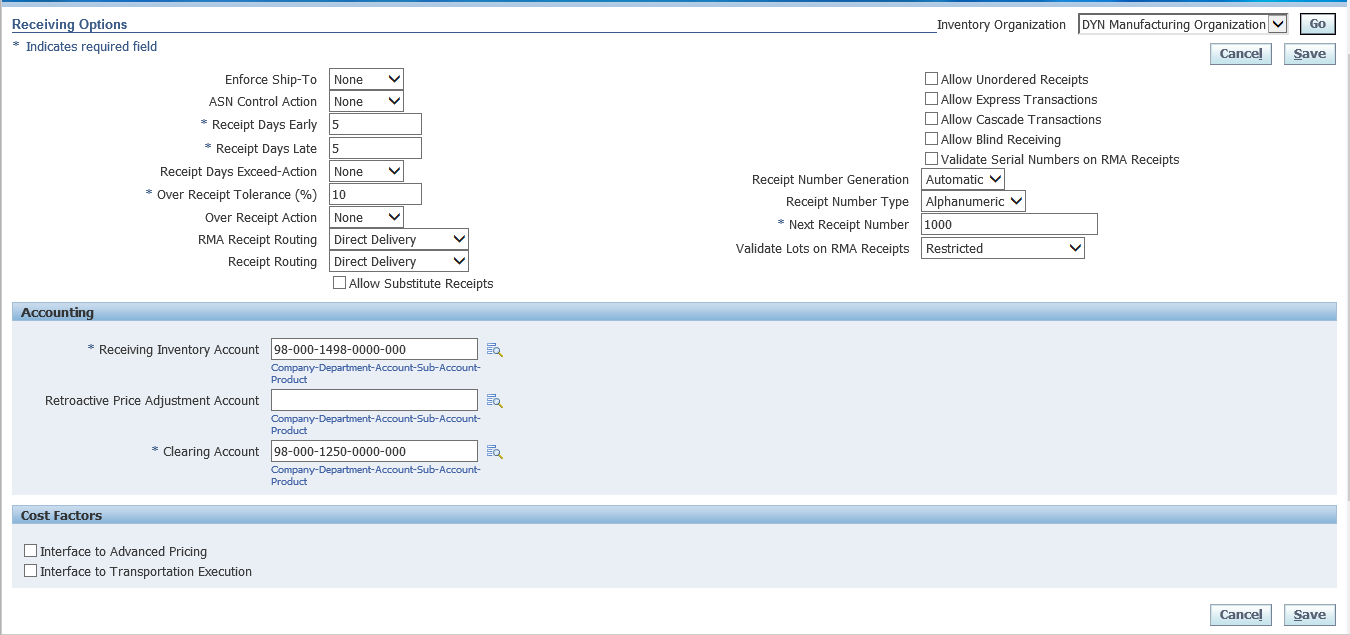

Enter Receiving Information:

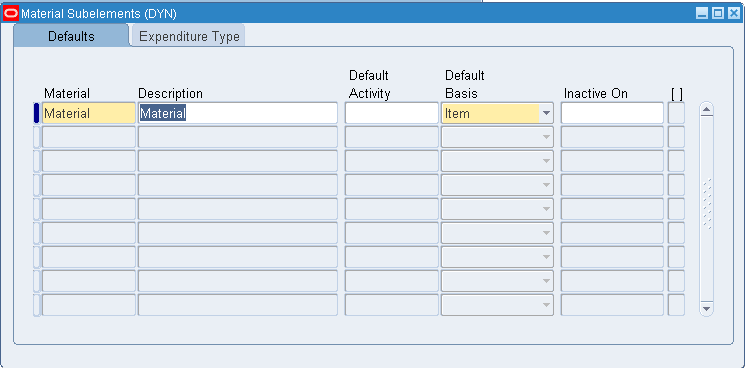

STEP 4: CREATE MATERIAL SUB-ELEMENTS
Responsibility: Inventory Navigation: Setup > Costs > Sub-Elements > Materials

STEP 5: DEFINE SUB-INVENTORY
Responsibility: Inventory Navigation: Setup > Organizations > Sub-inventories

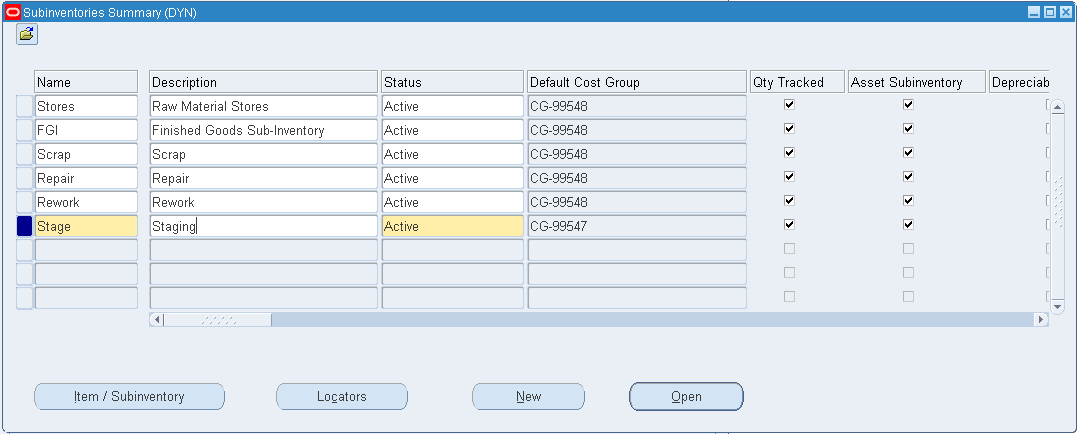

Create the below sub-inventories under the newly created manufacturing organization

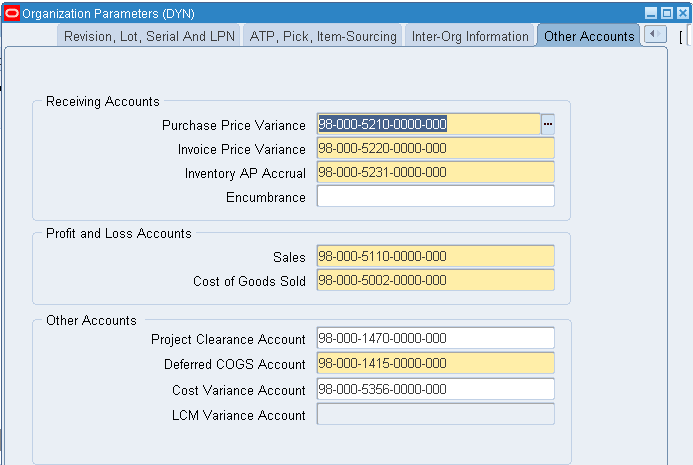

STEP 6: DEFINE BOM PARAMETERS
Responsibility: Bills Of Materials Navigation: Setup > Parameters

Note:
If you have not defined the BOM Parameters then you will get the below error message while opening the Bills form

STEP 7: DEFINE EXCEPTION TEMPLATES
Responsibility: Bills Of Material Navigation: Setup > Calendar OR Exception Templates
Query the Manufacturing "Calendar" and click on "Dates"

As per the manufacturing calendar, all Sundays are leave. In case of any business requirement if you would like to make some Sundays as a working day then you can define the Exception Templates and enter those days as a working days
Click on "Exception List"
Click "OK"
As soon as you save the Exception List, it will reflect in your calendar

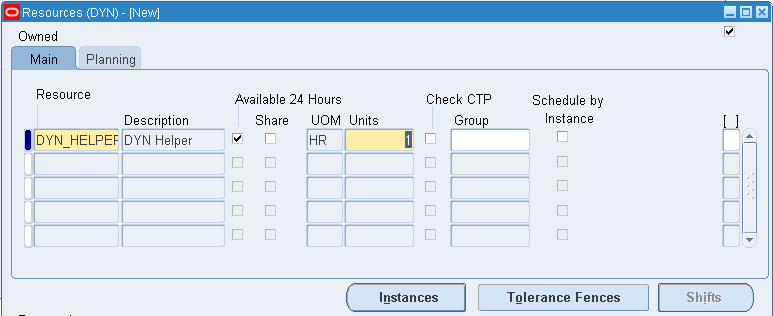

STEP 8: DEFINE RESOURCES
Responsibility: Bills of Materials Navigation: Routing > Resources

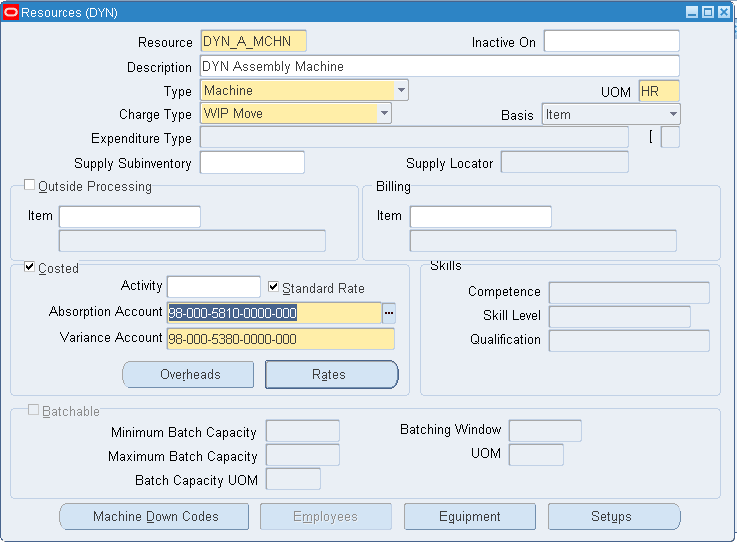

Define one Assembly Machine Resource with Charge Type as "WIP Move"

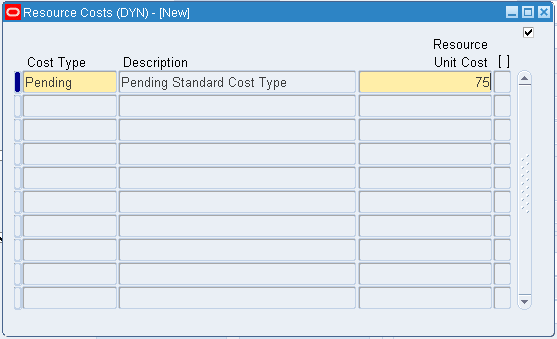

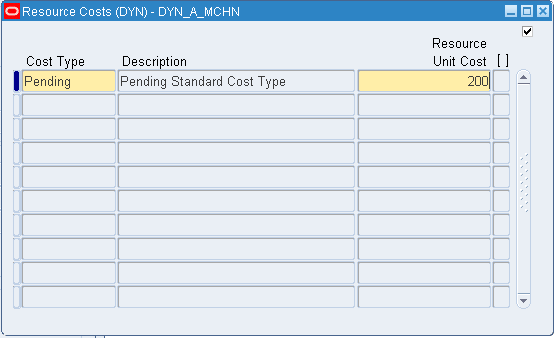

Define Resource Rates:

After enabling the "Costed" and "Standard Rate" check boxes, click on "Rates"
Save and close this form.
Likewise create one Assembly Person Resource with Charge Type as "WIP Move"
Click on "Rates"
Note:
1. Defined the below Resources
Resource Name
Description
Type
UOM
Charge Type
Rate
DYN_A_MCHN
DYN Assembly Machine
Machine
HR
WIP Move
200
DYN_A_LBR
DYN Assembly Labour
Person
HR
WIP Move
75
DYN_HELPER
DYN Helper
Person
HR
WIP Move
50
DYN_TESTER
DYN Tester
Person
HR
WIP Move
100

2. Various Resource Types:
  • Amount - We can use this type when we use money transactions
  • Currency - We can use this type when we use USD currency for transactions.
  • Machine - We can use this type when the resource is a Machine
  • Miscellaneous - We can use this type during OSP or other transactions
  • Person - We can use this type when the resource is a Human/Person
3. Various Charge Types:
  • Manual - Charges will trigger when we manually move the Resources in Jobs
  • PO Receipt - Charges will trigger when we do PO Receipts for OSP Purchase Orders
  • PO Move - Charges will trigger when we complete the PO Receipts and do Move Transactions in OSP Operation
  • WIP Move - Charge will trigger when we do the Move Transactions in Discrete Jobs
4. When defining the Rates for Resources, we should define the rates using "Pending" Cost Types. Because this is a Standard Costing Organization.

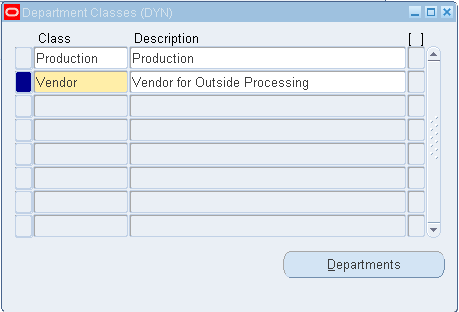

STEP 9: DEFINE DEPARTMENT CLASSES
You can define department classes to group departments and to identify manufacturing cells. This information is for your reference only.
Responsibility: Bills Of Materials Navigation: Setup > Department Classes
Enter the Department Classes and it's Description
STEP 10: DEFINE DEPARTMENTS
You can define departments as areas within your organization where you perform work and/or collect costs.
Responsibility: Bills of Materials Navigation: Routings > Departments

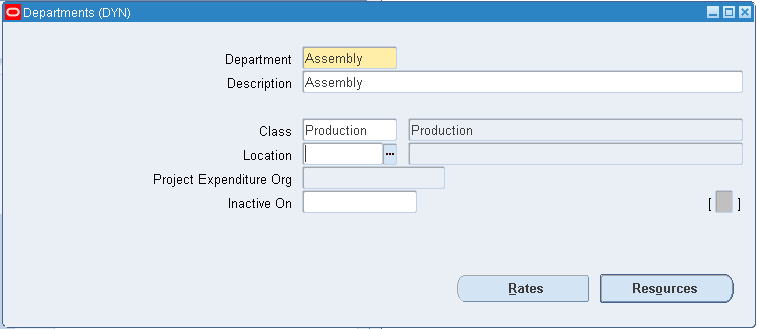

Enter the Department Name and Description along with the Department Class

Assign Resources to department:

Click on "Resources"
Attached two resources for the Department "Assembly"
If you want to enter the Overhead Rates for this Department then you can click on Rates and enter the Amount

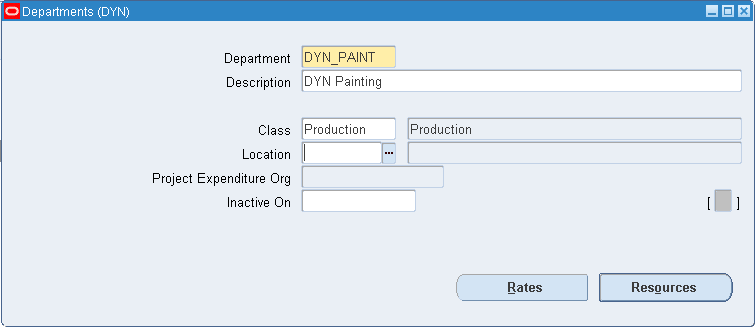

Create a Department for Painting and Assign the Resource
Click on "Resources"
Define one more department for QC and assign the resource
Note:
All the department resources are available for 24 Hours. If that department resource is not available for 24 hours then uncheck "Available 24 Hours" check box and enter the timing in "Shifts"

STEP 11: DEFINE STANDARD OPERATIONS
Responsibility: Bills Of Materials Navigation: Routing > Standard Operations
Enter the Standard Operations Code and attach the Department

Assign Resources to Standard Operations:

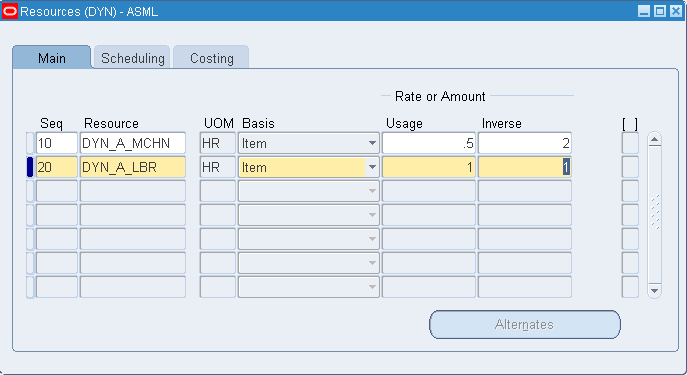

Click on "Operation Resources" and assign the Resources
Usage & Inverse: If we use the Resource "DYN_A_MCHN" for half an hour (Usage) then we can produce 1 unit (Inverse). Otherwise, if we want 2 Units output then we need to use the resource "DYN_A_MCHN" for 1 hour. At the same time, if we use the resource "DYN_A_LBR" for 1 hour then we will produce 1 Unit.

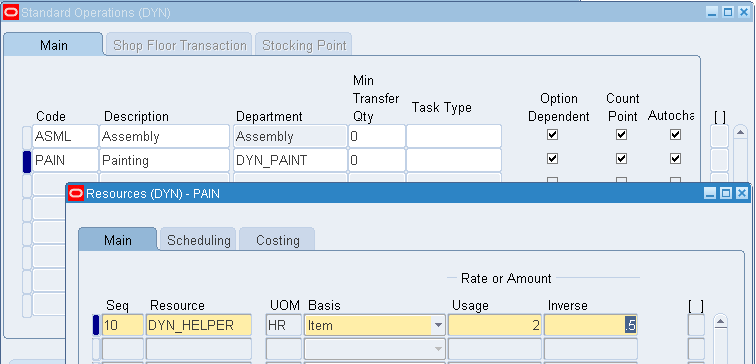

Likewise create the Standard Operations for Painting
Create on Standard Operation for Quality Checking
Note:
We should use the Painting resource for 2 hours to produce 1 unit. In other words, the painting resource can produce only half unit in 1 hour.
Similarly the tester resource can produce 1 unit in 1 hour.
Usage: How many hours we should use one particular resource to produce 1 Unit?
Inverse: What is the Output of one resource if we use that resource for 1 hour?
STEP 12: CREATE ITEMS
Create the below items and apply the proper item templates and then assign the cost.
Items
Template
Cost
DYN_CAR
Finished Goods

DYN_Engine
Purchased Item
500
DYN_Chasis
Purchased Item
400
DYN_Seat
Purchased Item
75
DYN_Wheel
Sub-Assembly

DYN_Tyre
Purchased Item
25
DYN_Rim
Purchased Item
30
DYN_Axle
Purchased Item
20

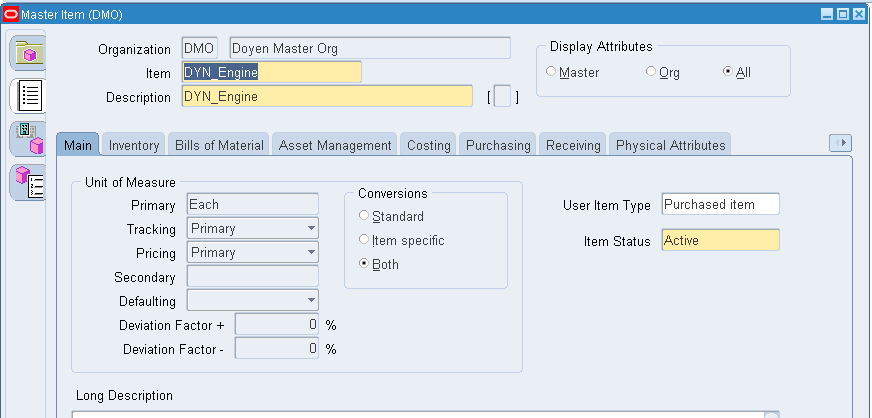

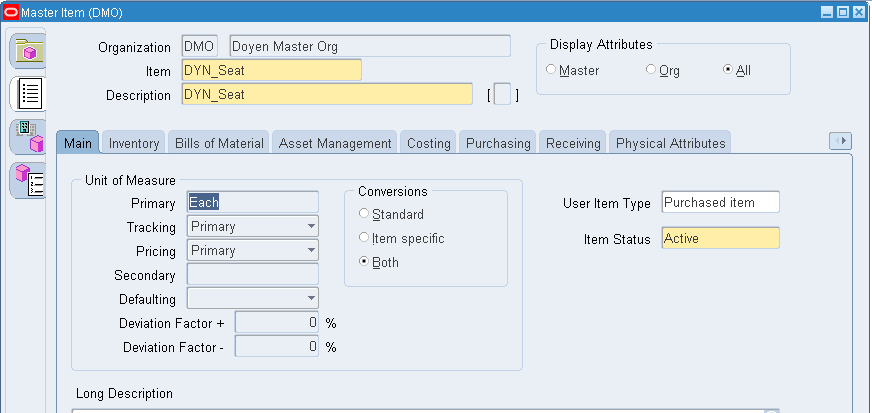

Responsibility: Inventory Navigation: Items > Master Items

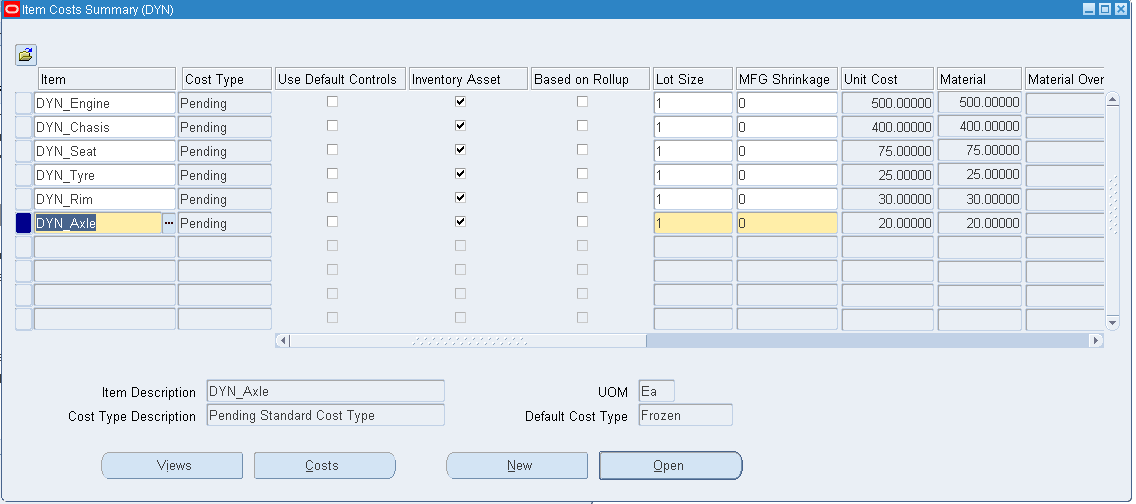

STEP 13: ENTER ITEM COST
Responsibility: Inventory Navigation: Costs > Item Costs

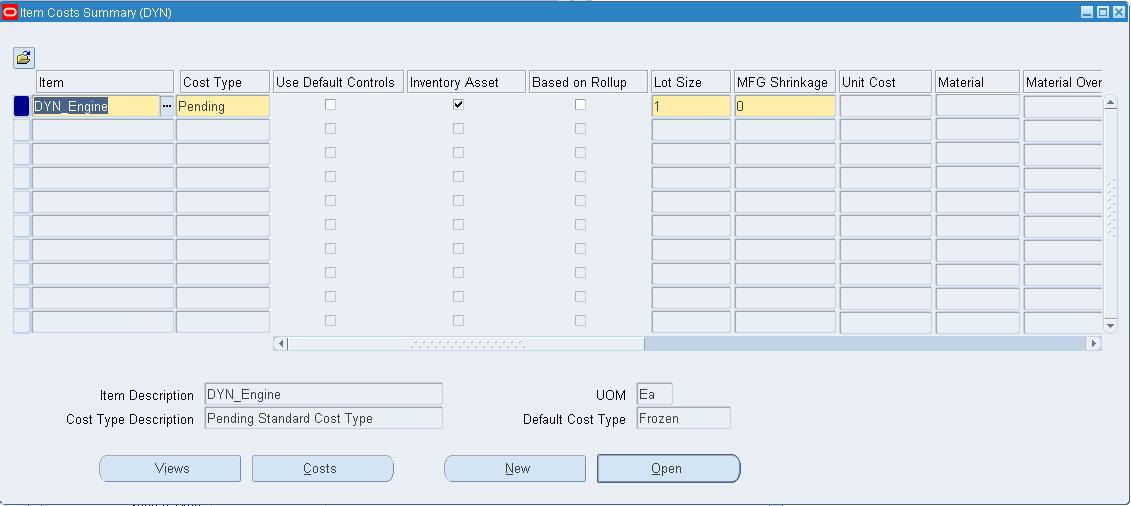

Click on "New" and enter the Item Code and Cost Type as "Pending"
Click on "Open" and then "Costs"
Likewise enter the costs for remaining items
If you query these items again then, we can see one more record for each and every item in "Frozen" cost type
Note:
For every item will have 2 records. One record will be in "Pending" Cost Type and the another one will be in "Frozen" cost type. Because, this DYN Organization is a Standard Cost Organization. By default the item cost will be defined in "Pending" cost type. Then if we run the "Update Standard Cost" program then the cost will be moved to "Frozen" Cost Type.

STEP 14: DEFINE OVERHEADS

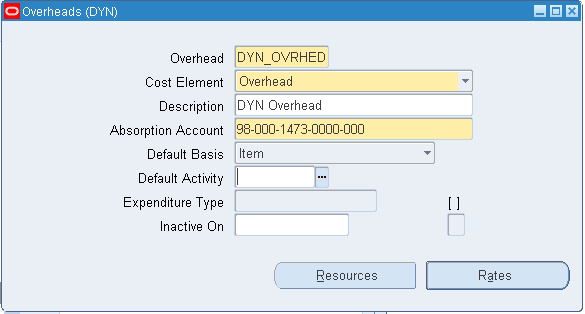

Responsibility: Inventory Navigation: Setup > Costs > Sub-Elements > Overheads

Enter the Overhead Name and select the Cost Element then enter the Overhead Absorption Account

Assign Overhead department and overhead Rates:

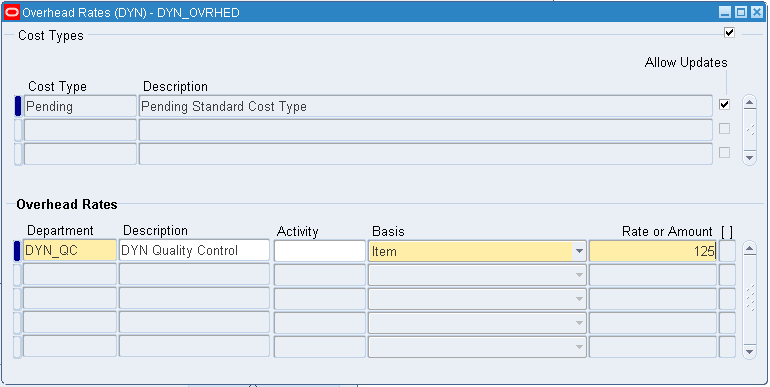

Click on "Rates" and enter the Overhead Amount
While entering the Overhead Rates, we need to enter the Department Name as well.
Basis = Item
Means, this Overhead Rate will be based on the item. Whenever we are using the Department "DYN_QC" this Overhead rate 125 USD will be applied.

assign Overhead Resources:

Click on "Resources" and assign that Resource (Whatever the Department you have assigned, assign that department resource to this Overhead.

STEP 15: DEFINE ROUTING
Responsibility: Bills Of Material Navigation: Routings > Routings
Select the Organization as "DYN" and create the Routings for both the Assembly items

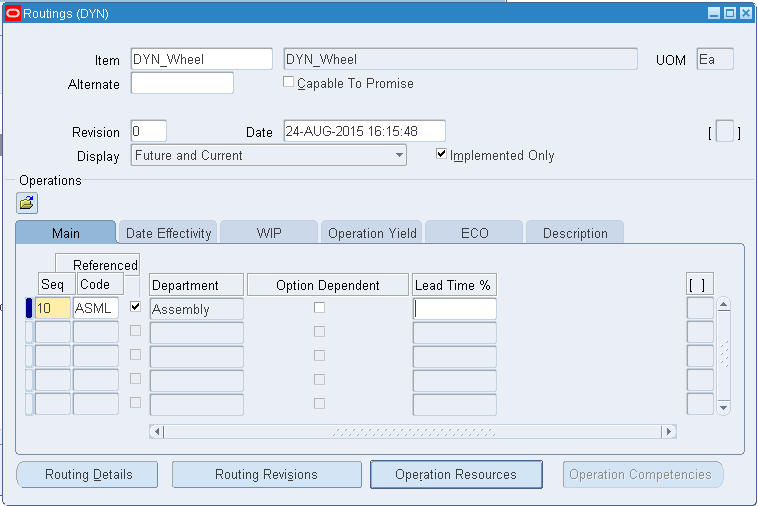

First create the Routings for the Sub-Assembly item " DYN_Wheel"

Likewise create the Routings for the End Assembly item "DYN_CAR"

STEP 16: DEFINE BILLS
Responsibility: Bills Of Materials Navigation: Bills > Bills
First, create the Bills for Sub-Assembly item and then create the Bills for Main Assembly Item

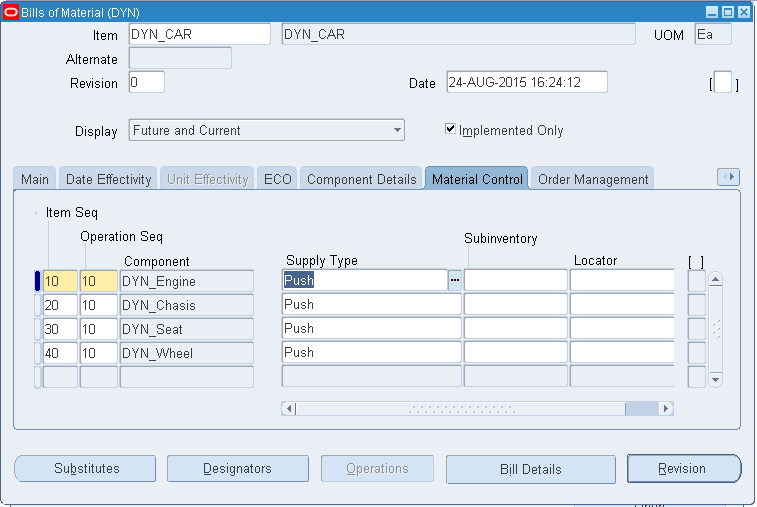

Make it the Supply Type as "Push"

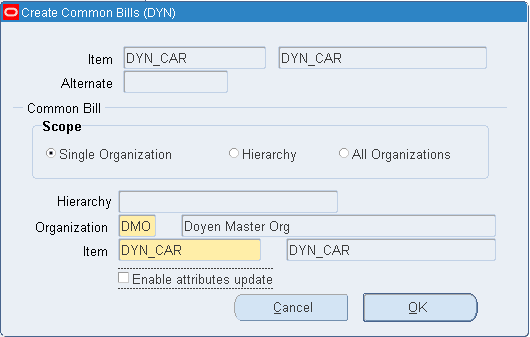

Create Common Bills:

This Bill was created in "DYN" organization and it's a manufacturing org. So, we need to create the Bill in Master Organization as well. To create the Common Bill in Master Org, navigate to

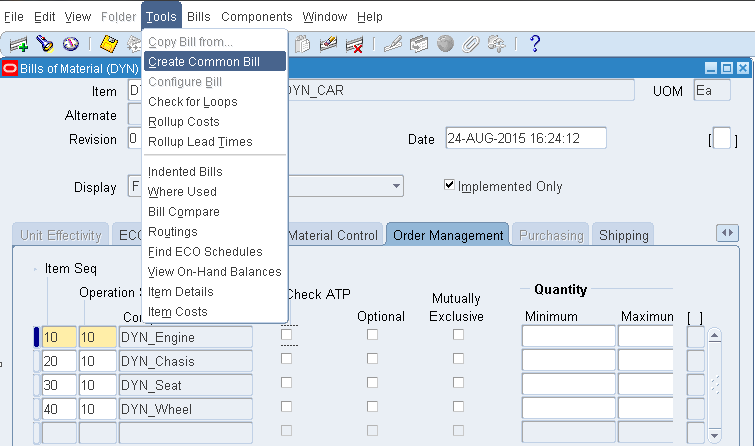

Tools > Create Common Bills
Enter the Master Organization and the item
Click on "OK"
"Create Common Bills" program will be submitted automatically
Query this Bill in Master Org "DMO" and it will be available
This completes the Bill Of Materials

STEP 17: UPDATE STANDARD COST:
Responsibility: Inventory Navigation: Costs > Standard Cost Update > Update Costs
Run the "Update Standard Costs" program for "Pending" Cost Type
"Submit" the " Update Standard Costs" program in DYN Organization
Note:
Make sure the Inventory Period is open for our organization "DYN"

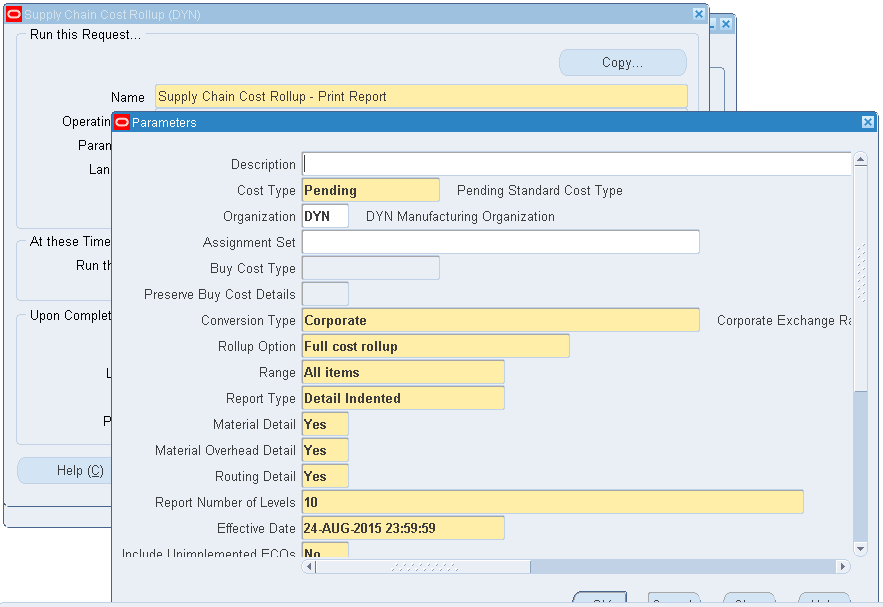

STEP 18: RUN COST ROLL-UP
Responsibility: Cost Management SLA
Navigation: Supply Chain Costing > Supply Chain Cost Rollup

Submit a single request "Supply Chain Cost Rollup - Print Report"
Check the Output for "Supply Chain Cost Rollup - Print Report"

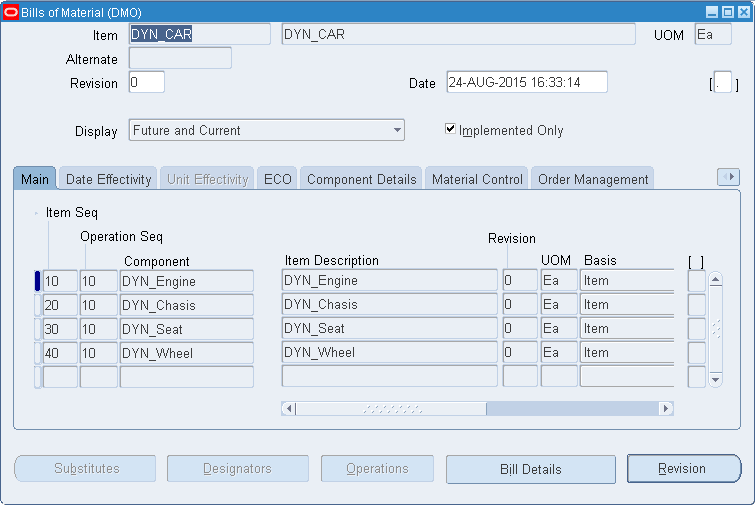

Item Roll-up Cost for "DYN_CAR"

STEP 19: COST ROLL-UP CALCULATION:

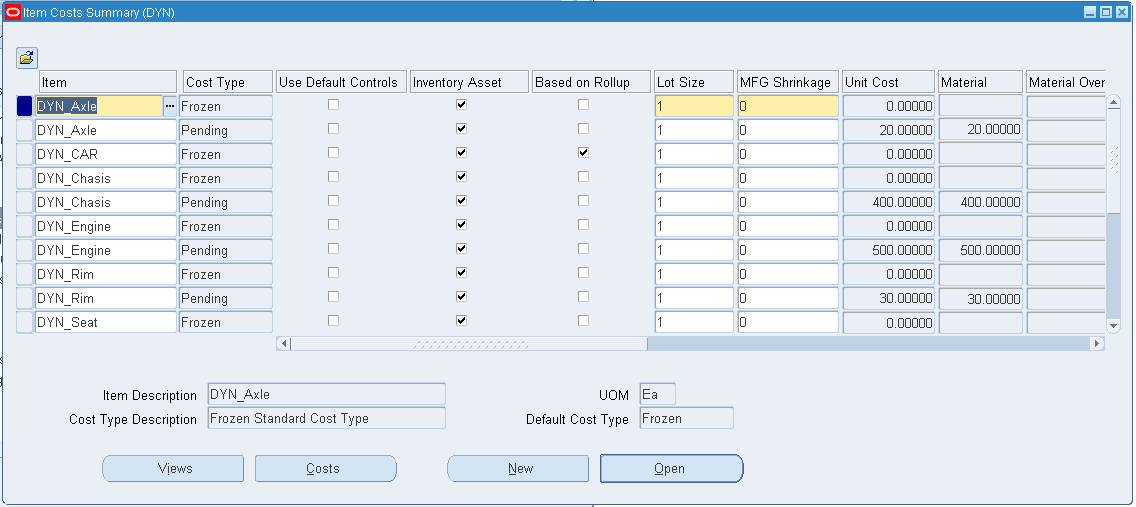

Material Cost:

Items
Template
Item Cost
Qty Required
Material Cost
DYN_CAR
Finished Goods

1
1385
DYN_Engine
Purchased Item
500
1
500
DYN_Chasis
Purchased Item
400
1
400
DYN_Seat
Purchased Item
75
3
225
DYN_Wheel
Sub-Assembly

1
260
DYN_Tyre
Purchased Item
25
4
100
DYN_Rim
Purchased Item
30
4
120
DYN_Axle
Purchased Item
20
2
40

Resource Cost:

Resource Name
Type
Item
UOM
Charge Type
Usage
Inverse
Rate
Total Amount
DYN_A_MCHN
Machine
DYN_CAR
HR
WIP Move
0.5
2
200
100
DYN_A_LBR
Person

HR
WIP Move
1
1
75
75
DYN_HELPER
Person

HR
WIP Move
2
0.5
50
100
DYN_TESTER
Person

HR
WIP Move
1
1
100
100
DYN_A_MCHN
Machine
DYN_Wheel
HR
WIP Move
0.5
2
200
100
DYN_A_LBR
Person

HR
WIP Move
1
1
75
75
Total Resource Cost
550

Overhead Cost:

Name
Department
Resources
Rate
DYN_OVRHED
DYN_QC
DYN_TESTER
125

Roll-up Cost for Item "DYN_Wheel"

  • Material Cost: 260
  • Resource Cost: 175
  • Overhead Cost: 0
Total Cost: 260 + 175 = 435

Roll-up Cost for Item "DYN_CAR"

  • Material Cost: 1385
  • Resource Cost: 100 + 75 + 100 + 100 + 175 = 550
  • Overhead Cost: 125

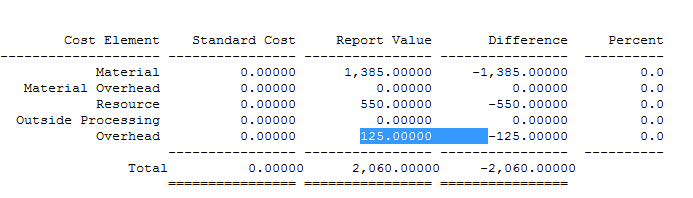

Total Cost: 1385 + 550 + 125 = 2060 USD

----- RAJU DEVARAJ
drajudevaraj@gmail.com
